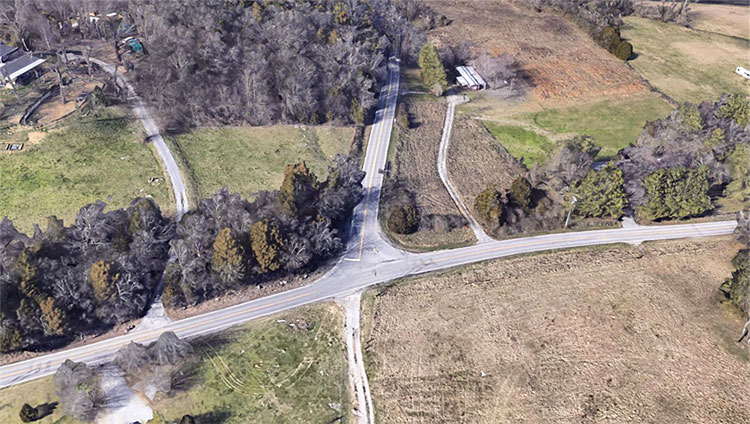

Project Limits
Intersection of Blue Hole Road and Pettus Road (0.40 miles)
Council District 31: Council Member John Rutherford
December 2023
Phase: Construction

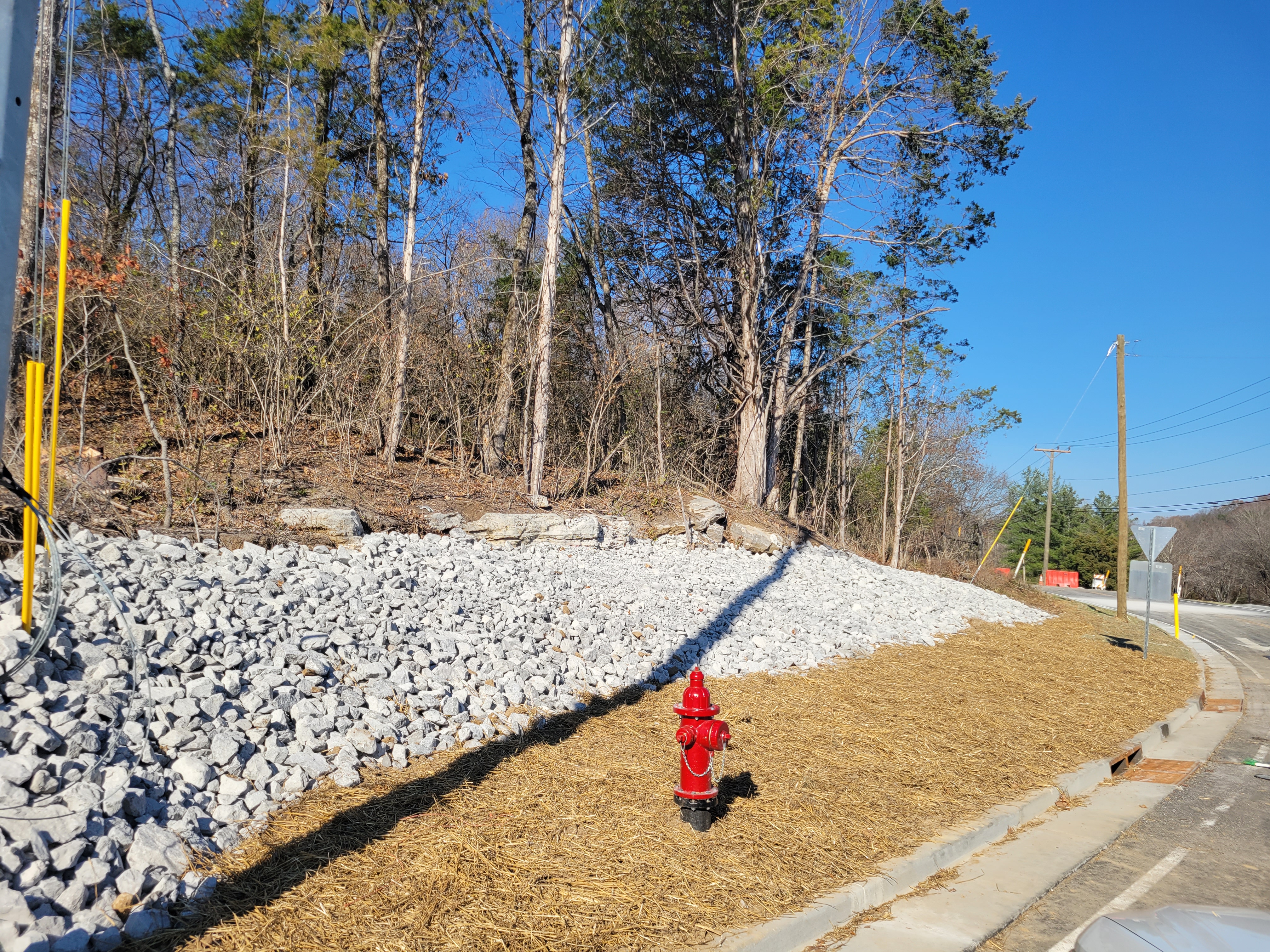

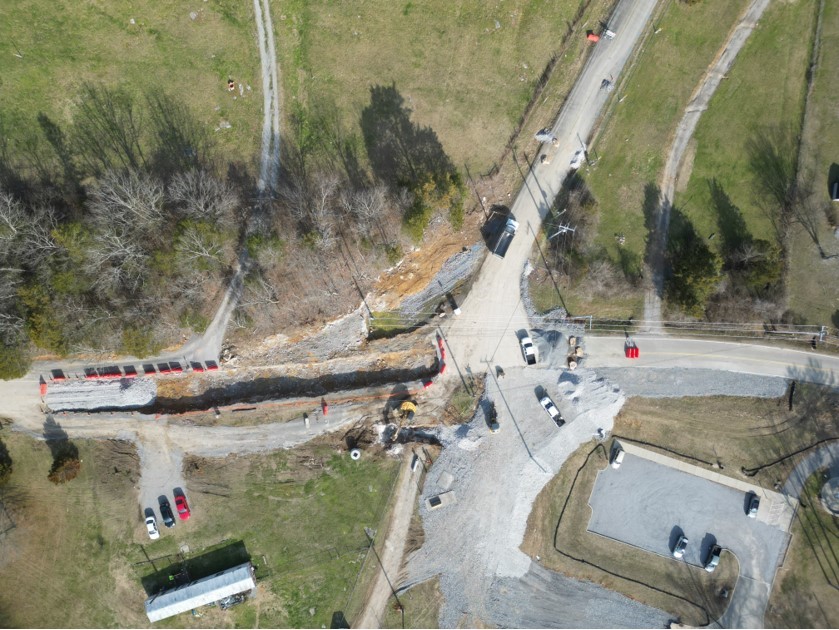

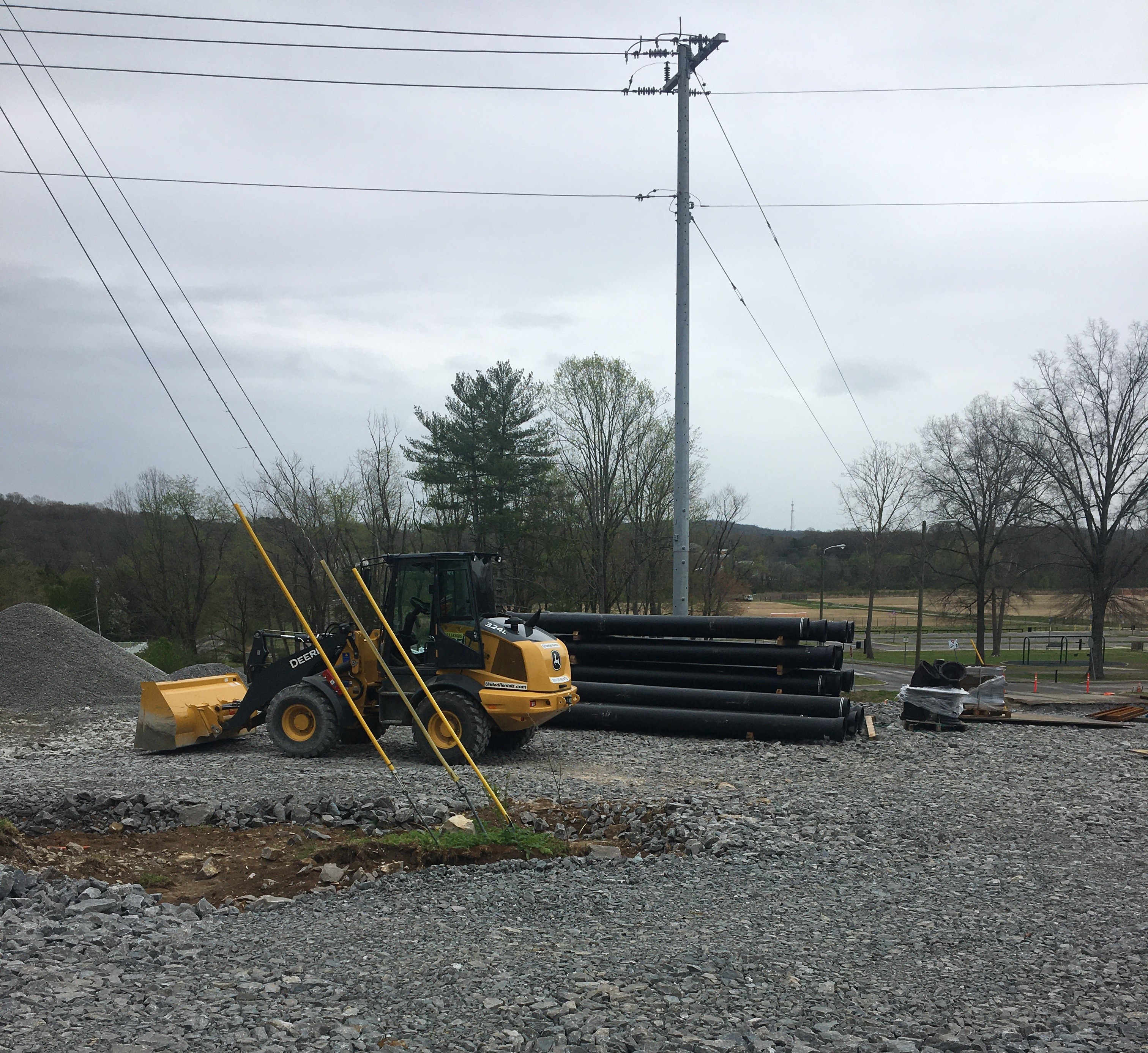

Final paving was completed the week of December 4, 2023. The roadway was reopened on Monday, December 11. This project is complete.
Project Description
Project involves the design and construction of a roundabout at the intersection of Blue Hole Road and Pettus Road. The roundabout will be one-lane and will also serve as a gateway entrance into Orchard Bend Park.
- Length: Blue Hole Road project limits are 900 linear feet; Pettus Road is 1200 linear feet (0.40 miles)
- Cross-Section: travel lanes approaching roundabout are from 10 to 12 feet; within roundabout, lanes are 16 feet.
- Estimated Project Cost: $2,900,000
Project Funding: 100% Local
Timeline
Note: Estimated timeline dates are subject-to-change based on most current projected schedules from multiple vendors and departments.
- Conceptual Design: January 2018 to May 2018
- Design (Plan Development): Completed January 2021

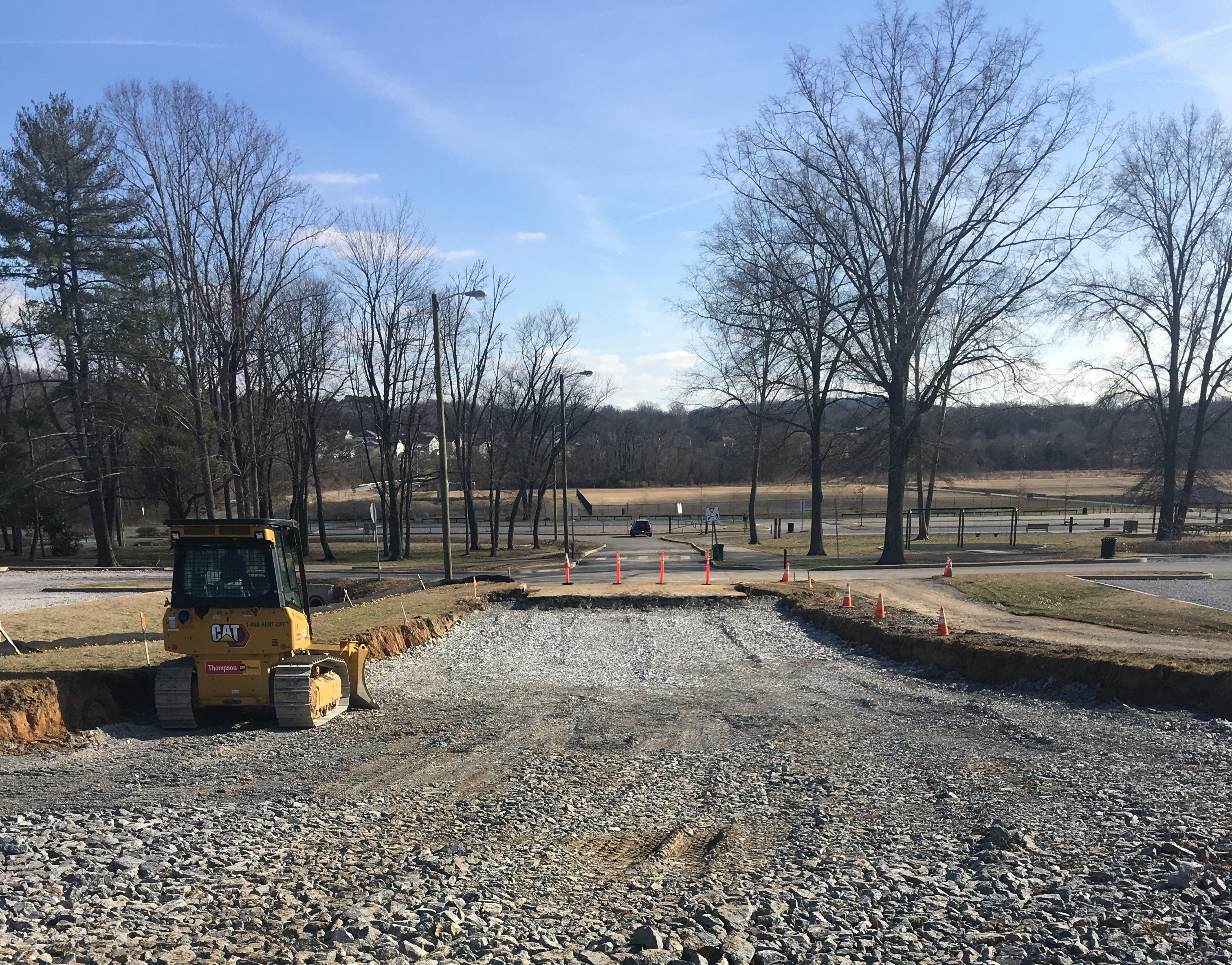

- Right-of-Way Acquisition: Completed January 2022
- Utility Coordination: July 2019 to present

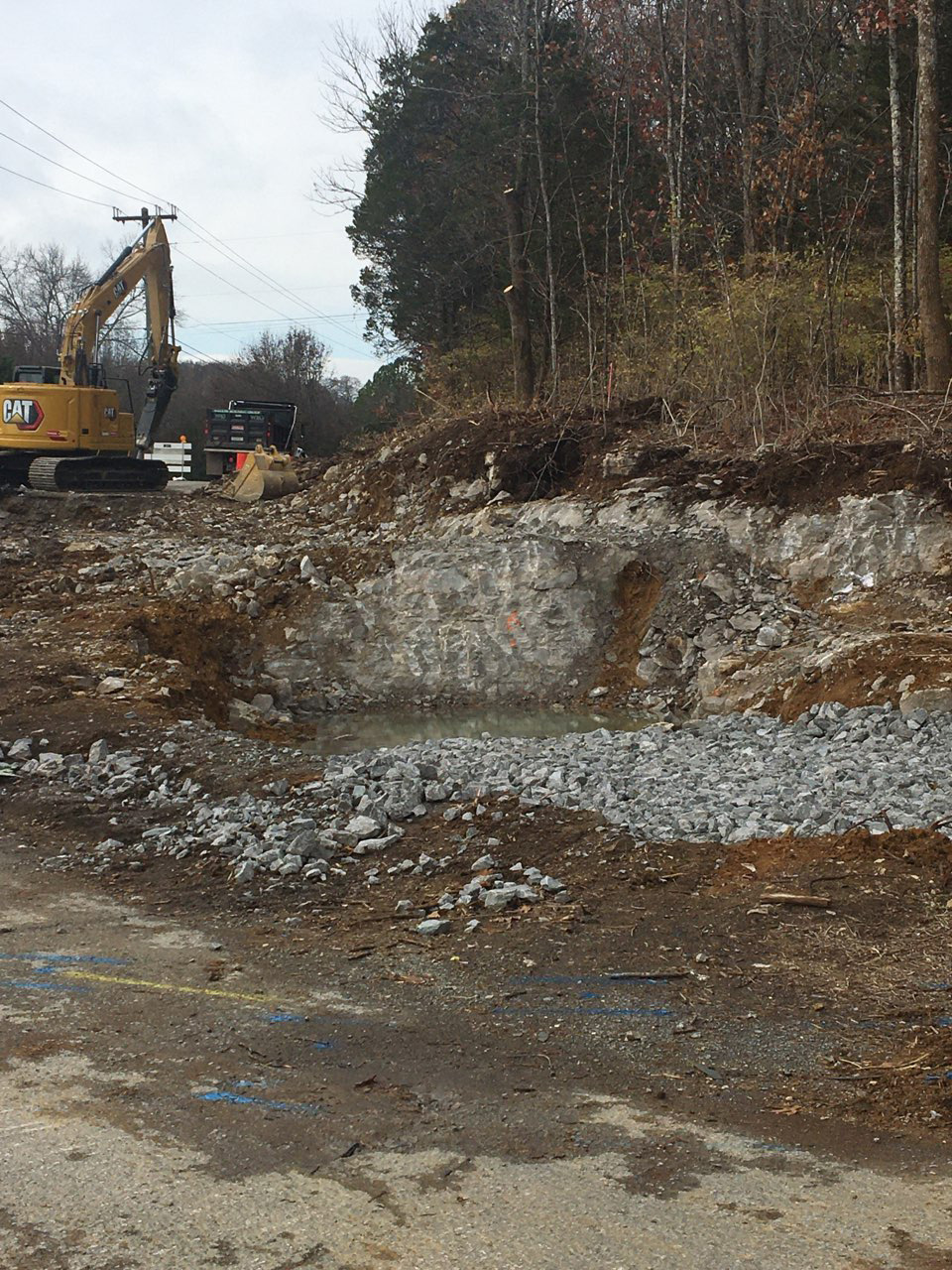

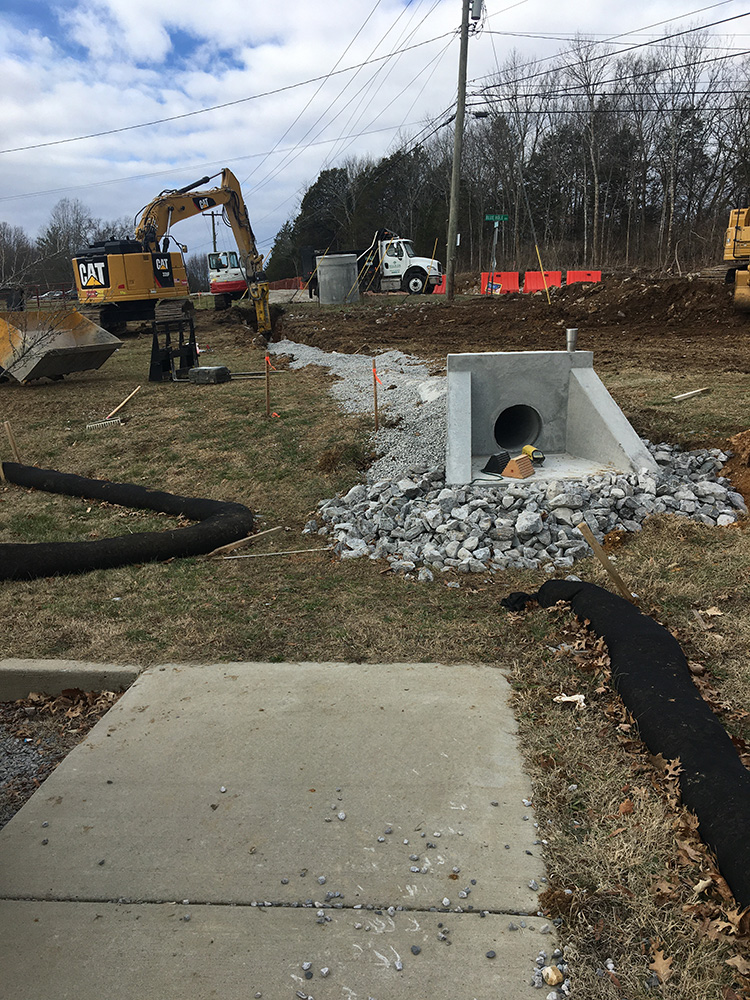

- Construction Start: November 2022
- Estimated Construction Duration: 12 to 18 months

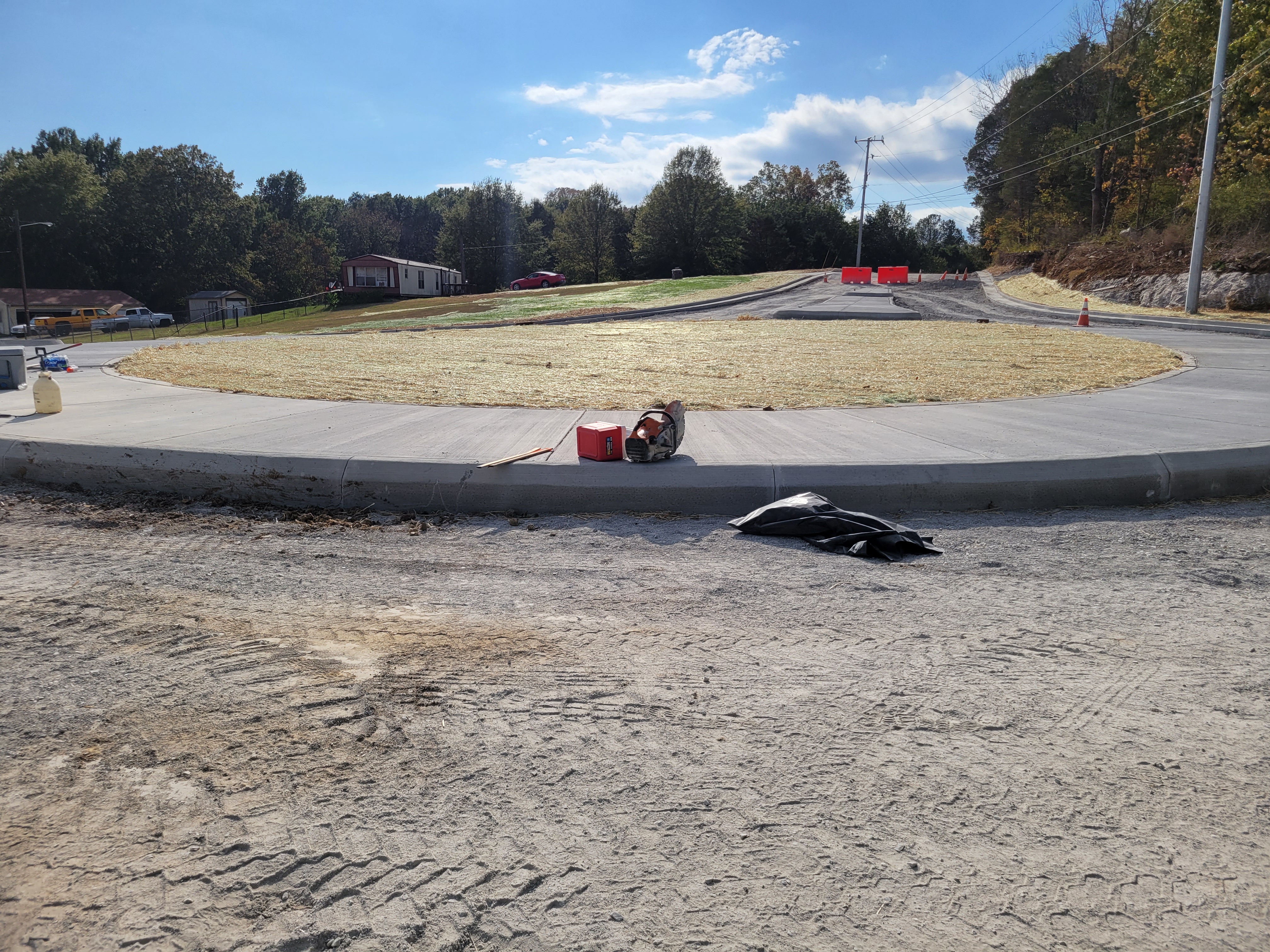

- Estimated Construction Completion: November 2023

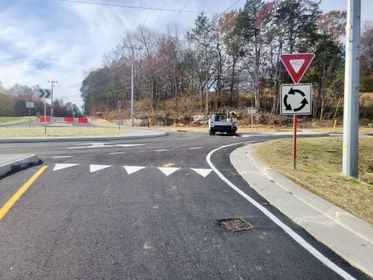

- Actual Completion: December 11, 2023
For more information, please contact the Metro Project Manager at 615-862-8730.
